Unlock Your Project: How to Secure a Building Permit in Vancouver

How to Handle Construction Site Permits

NewsJanuary 24, 2026CoreVal Homes

TL;DR

A clear walkthrough of the Vancouver building permit process for homeowners, from application to occupancy, and how to avoid the common delays that stall projects.

Start by checking whether your project needs a development permit, then submit a complete electronic application through your City of Vancouver permit account and answer staff requests quickly. CoreVal's David Bond says the permit stage can take 3 weeks or 10 or more. A Vancouver building permit must be issued before any work begins, so plan your schedule around it.

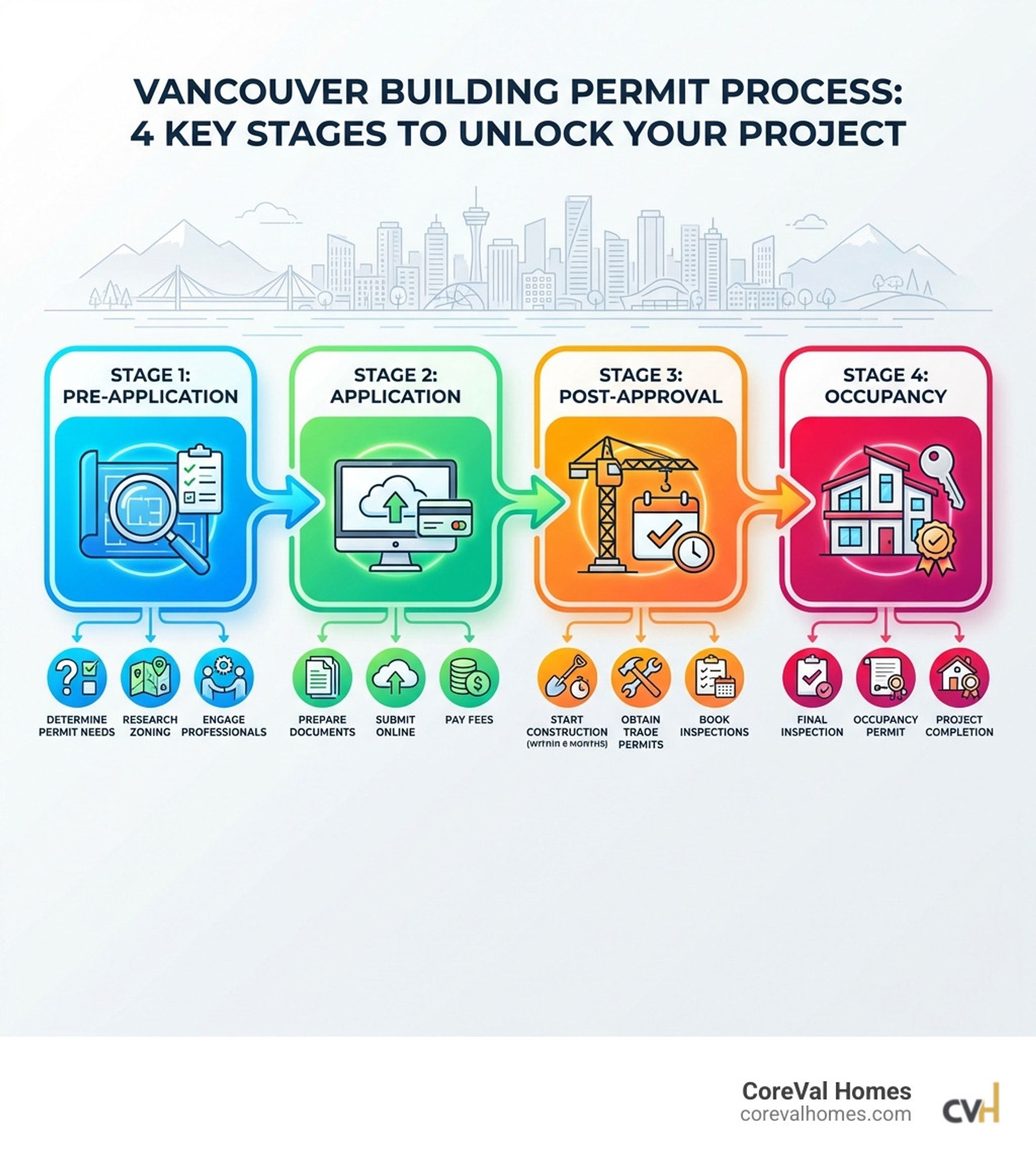

Infographic: the Vancouver building permit process in four stages, from pre-application to occupancy
CoreVal Homes

Do I Need a Development Permit Before a Building Permit?

Most construction, changes of land use and changes of occupancy on private property need a permit. That covers new homes, laneway homes, additions, demolitions and interior work that moves structural walls or creates a secondary suite. The City lists the details on its when you need a permit page. Starting without one can lead to fines, delays and orders to remove unapproved work.

Some projects need a development permit first. This is common for larger projects, land use changes and requests for zoning relaxations. If yours is one of them, the development permit comes first. Once it is issued, you generally have 12 months to apply for the building permit, according to the City's development permit guidance. Zoning sets what you can build, so read our guide to zoning categories in Vancouver before you design anything.

This is where an early advisor pays off. David Bond, CoreVal's President, says: "At CoreVal, we have an internal permit coordination department, which makes a big difference." He adds that through experience and continuous education, "we stay ahead of changes and position ourselves as real advisors to our clients."

Smiling man in a knit beanie in front of a whiteboard with flowchart sketches
CoreVal Homes

What Does the Application Package Need?

Vancouver accepts applications electronically only, and the technical rules catch many first-time applicants. The City's requirements include:

  • PDF files only, with each file under 300MB. Split large drawing sets by discipline, such as architectural and structural.
  • Vector-based PDFs where possible, because scanned paper drawings may be rejected.
  • A blank space in each title block, at least 2 inches wide by 3 inches tall, for the City's stamp.
  • A professional seal plus a valid digital signature on documents that need an architect or engineer. A scanned seal is not enough. See the Engineers and Geoscientists BC guidance.
  • No password-protected or locked PDFs, since City staff need to apply stamps and signatures.

Upload everything through your online permit account. The City checks the application for completeness and then calculates the fees. You can pay online by credit card, by mail, or in person at 515 W 10th Ave, where cash payments have a limit.

Building permit sign on a Vancouver construction site with an excavator and high-rise towers behind
CoreVal Homes

How Long Does the Permit Stage Really Take?

The permit is one stage in a longer sequence. Using the timeline Bond describes for custom and laneway homes, a typical run looks like this:

  • Initial call and site visit: about 2 weeks.
  • Rough numbers and discussion with you: another 1 to 2 weeks.
  • Design, revisions and specialists: 4 to 6 weeks.
  • Permits: 3 weeks to 10 or more.

Added together, that is roughly 10 to 20 weeks or more before construction starts. Building itself usually takes 8 to 12 months. The permit line is the one you do not control, and Bond is blunt about it: "Permits... that's the part everyone underestimates. It can be 3 weeks, it can be 10+, and you don't fully control it."

CoreVal uses that waiting period to plan the build and finalize details. When the permit is issued, you get an email and download the permit and stamped drawings from your account. Nothing needs to be picked up in person.

Two rules apply once you have it. You must start work within 6 months of issuance or the permit becomes void and you reapply. You also need one printed copy of the permit and a full-sized paper set of the approved drawings on site for inspectors, per the City's Vancouver Building By-law information.

How Do You Keep a Permit Moving?

Applications stall when nobody owns the follow-up. Staff may post questions or deficiencies in your permit account, and you answer with revised drawings or added information. Bond puts it plainly: "If you're not proactive, things just sit."

CoreVal handles this with a dedicated permits department that is hands-on. Bond says: "If we need to go in person to review plans, we go. If it means calling multiple times in a day to get answers, we'll do that too." He describes the role this way: "At the end of the day, we act as the client's agent. Our job is to push, follow up, and also make it easy for the city to work with us."

What surprises clients most, he says, "is just how detailed and time-consuming the process is. It's not just paperwork; it's coordination, revisions, back and forth."

A short checklist keeps you ahead of it:

  • Confirm zoning and whether a development permit comes first.
  • Have your architect or engineer prepare sealed, digitally signed PDFs with no password protection and the title block space left clear.
  • Check your permit account for staff messages and respond promptly.
  • Use the City's permit search to track status by address or permit number.
  • Set your construction start date inside the 6 month validity window.

The permit is not the last wait either. Bond warns that the last 5% of a build feels like the longest, with drying time, coordination and inspections that can make the site look quiet for a few days. CoreVal keeps clients informed through chat groups and quick responses, so there is no guessing while approvals and inspections run their course.

Related: general contractor for luxury homes · construction company for new homes in Richmond

Falcon

Share This Article

Enjoying our articles? Stay informed on real estate & development.

Make us your preferred source on Google

Project Assessment

Get a project-specific feasibility review

Share the property, scope, timeline, and budget range. CoreVal will review zoning, permit path, and project fit before recommending the next practical step.

Need a Permit Path Before You Build?

CoreVal reviews zoning, drawings, engineering needs, municipal comments, and inspection sequence before construction scope is finalized.

Explore Design and Permitting
